State law data

Mechanics Lien Deadlines by State: Preliminary Notice and Filing Windows

By ClauseAudit Research · 23 sources ·

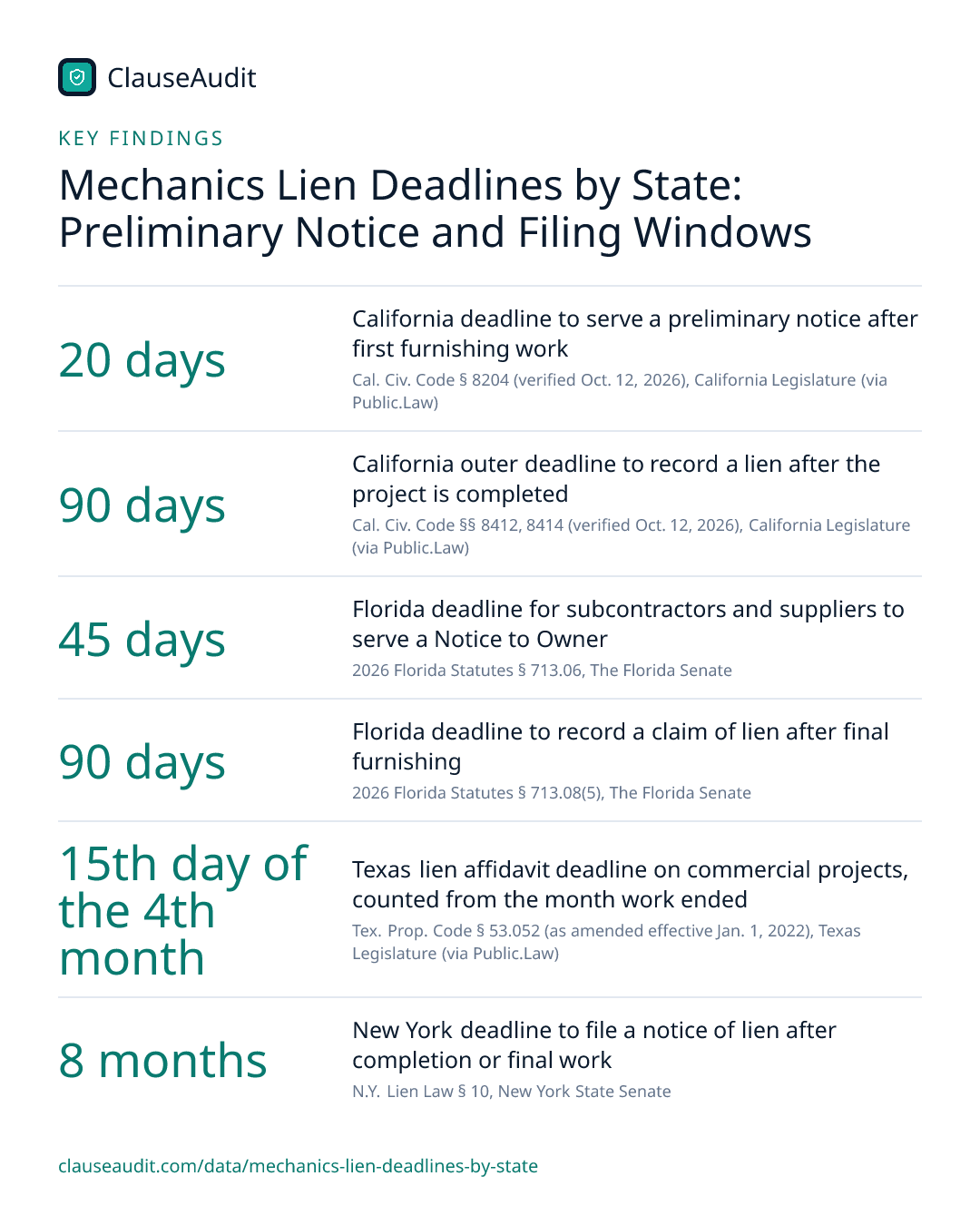

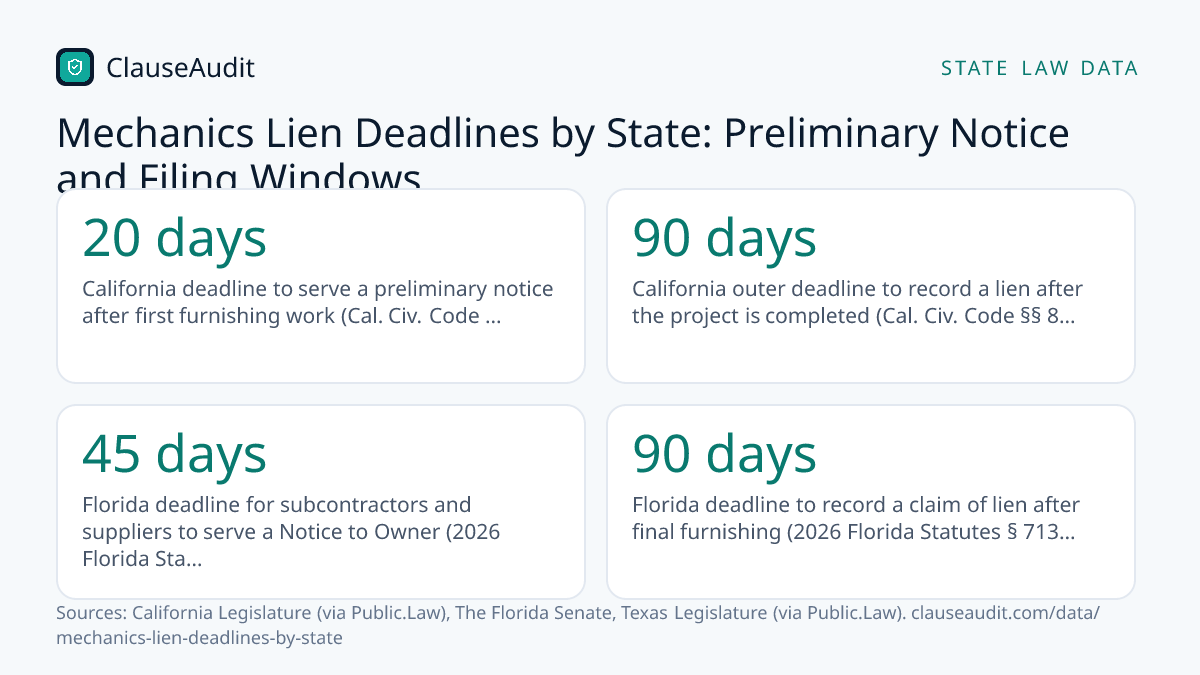

What are the mechanics lien deadlines by state?

Most states give a prime contractor 4 months or less after the work ends to file a mechanics lien, and 22 of the 50 states and DC allow 90 days or less. Many also want a preliminary notice early. In California it is due 20 days after you first furnish work.

A partly framed wooden house at dusk with sawhorses and stacked lumber on the bare lot
California deadline to serve a preliminary notice after first furnishing work (Cal. Civ. Code § 8204 (verified Oct. 12, 2026), California Legislature (via Public.Law))
20 days
California outer deadline to record a lien after the project is completed (Cal. Civ. Code §§ 8412, 8414 (verified Oct. 12, 2026), California Legislature (via Public.Law))
90 days
Florida deadline for subcontractors and suppliers to serve a Notice to Owner (2026 Florida Statutes § 713.06, The Florida Senate)
45 days
Florida deadline to record a claim of lien after final furnishing (2026 Florida Statutes § 713.08(5), The Florida Senate)
90 days
Texas lien affidavit deadline on commercial projects, counted from the month work ended (Tex. Prop. Code § 53.052 (as amended effective Jan. 1, 2022), Texas Legislature (via Public.Law))
15th day of the 4th month
New York deadline to file a notice of lien after completion or final work (N.Y. Lien Law § 10, New York State Senate)
8 months
Oregon deadline to perfect a construction lien, one of the shortest day-based windows (Or. Rev. Stat. § 87.035 (current through early 2026 per source), Oregon Legislature (via Public.Law))
75 days

A mechanics lien is the strongest collection tool a contractor, sub or supplier has. It ties your unpaid bill to the property itself, so the owner cannot sell or refinance cleanly until you are paid. The catch is timing. Miss the window and the right is gone, no matter how good your invoice is.

Each state sets its own clock, and many run two of them: a preliminary notice that starts when you begin work, and a filing deadline that starts when the work ends. The map and table below show both for every state and DC. This page explains how to read them and what to put in your contract so the deadlines work for you.

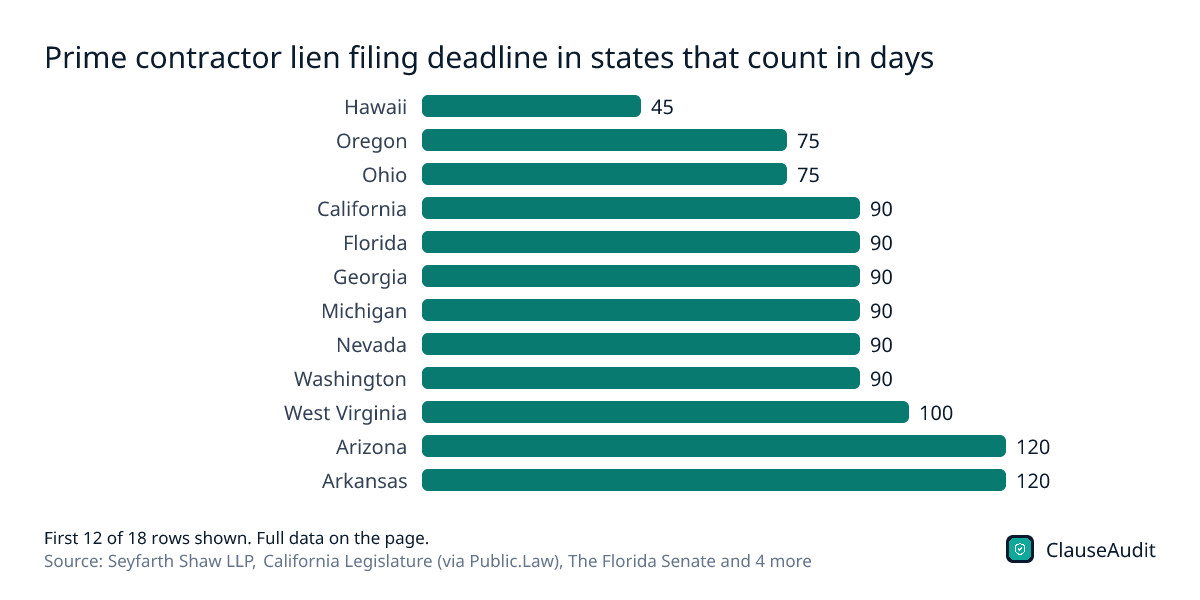

Prime contractor lien filing deadline in states that count in days

Prime contractor lien filing deadline in states that count in days: Hawaii 45; Oregon 75; Ohio 75; California 90; Florida 90; Georgia 90; Michigan 90; Nevada 90; Washington 90; West Virginia 100; Arizona 120; Arkansas 120; Minnesota 120; Nebraska 120; North Carolina 120; Delaware 180; Utah 180; Rhode Island 200Hawaii45Oregon75Ohio75California90Florida90Georgia90Michigan90Nevada90Washington90West Virginia100Arizona120Arkansas120Minnesota120Nebraska120North Carolina120Delaware180Utah180Rhode Island200
Chart data
LabelValue
Hawaii45
Oregon75
Ohio75
California90
Florida90
Georgia90
Michigan90
Nevada90
Washington90
West Virginia100
Arizona120
Arkansas120
Minnesota120
Nebraska120
North Carolina120
Delaware180
Utah180
Rhode Island200
Default window with no owner notice of completion. Counted from last furnishing in most states; from project completion in California, Arizona, Hawaii, Delaware, Utah and West Virginia. Rhode Island is a notice of intention. Source: Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update.

Hawaii is the outlier at 45 days, and Oregon and Ohio follow at 75. If you work in more than one state, set your reminders by the shortest window, not the one you know best.

Download this chart (PNG)

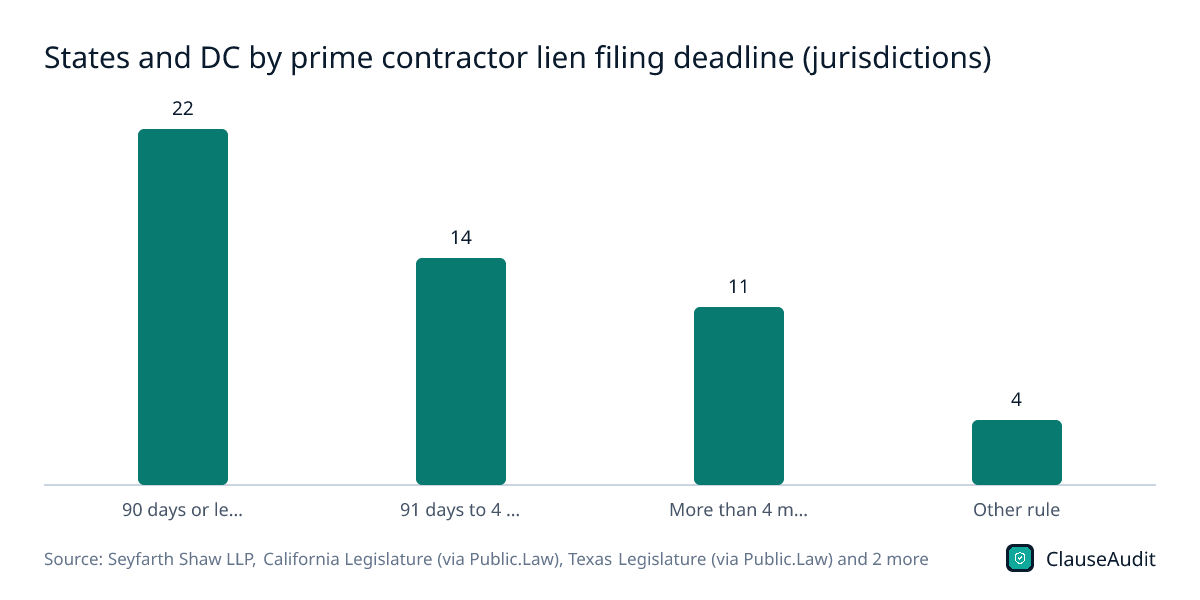

States and DC by prime contractor lien filing deadline (jurisdictions)

States and DC by prime contractor lien filing deadline90 days or less: 22; 91 days to 4 months: 14; More than 4 months: 11; Other rule: 4221411490 days or …91 days to …More than 4…Other rule
Chart data
LabelValue (jurisdictions)
90 days or less22
91 days to 4 months14
More than 4 months11
Other rule4
ClauseAudit tally of the 50 states and DC in the table below. 'Other rule' covers Louisiana, Maine, Texas and Vermont. Source: Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update; California Legislature (via Public.Law), California Civil Code § 8412; Texas Legislature (via Public.Law), Texas Property Code § 53.052; New York State Senate, New York Lien Law § 10; Mississippi Legislature (via FindLaw), Mississippi Code § 85-7-405.

22 jurisdictions sit at 90 days or less. Only 11 give more than 4 months, so a slow-paying client can easily outlast your lien rights.

Download this chart (PNG)

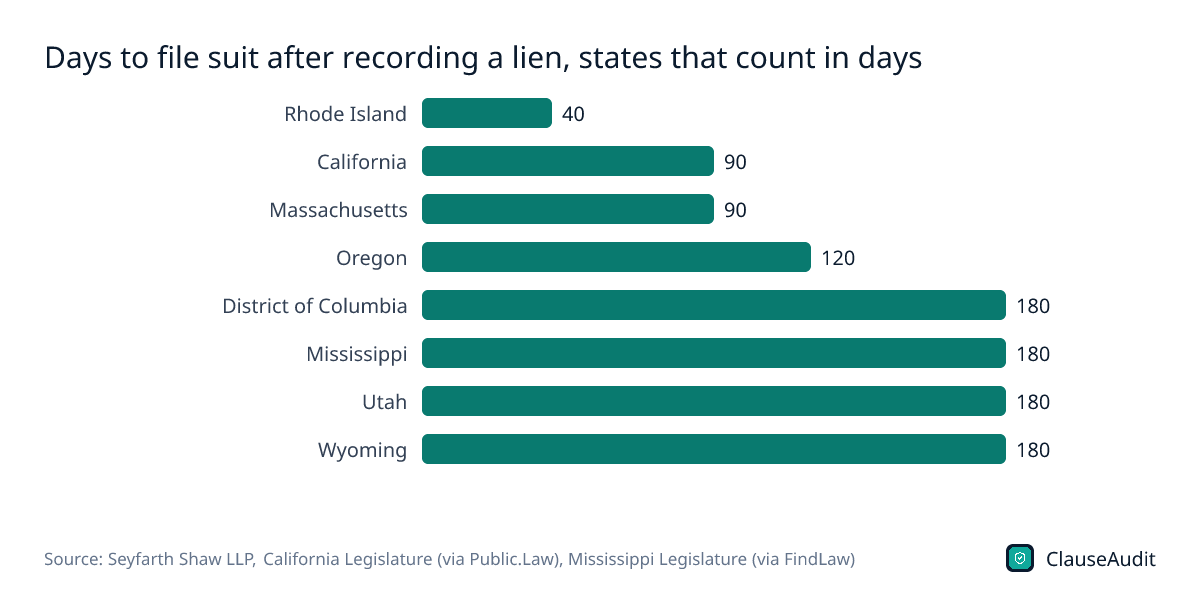

Days to file suit after recording a lien, states that count in days

Days to file suit after recording a lien, states that count in days: Rhode Island 40; California 90; Massachusetts 90; Oregon 120; District of Columbia 180; Mississippi 180; Utah 180; Wyoming 180Rhode Island40California90Massachusetts90Oregon120District of Columbia180Mississippi180Utah180Wyoming180
Chart data
LabelValue
Rhode Island40
California90
Massachusetts90
Oregon120
District of Columbia180
Mississippi180
Utah180
Wyoming180
Counted from recording the lien (Rhode Island: from recording the notice of intention; Massachusetts: from filing the statement of account). Source: Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update.

Filing the lien is not the finish line. Rhode Island gives 40 days to sue after the notice of intention, and California gives 90 days after recording.

Download this chart (PNG)

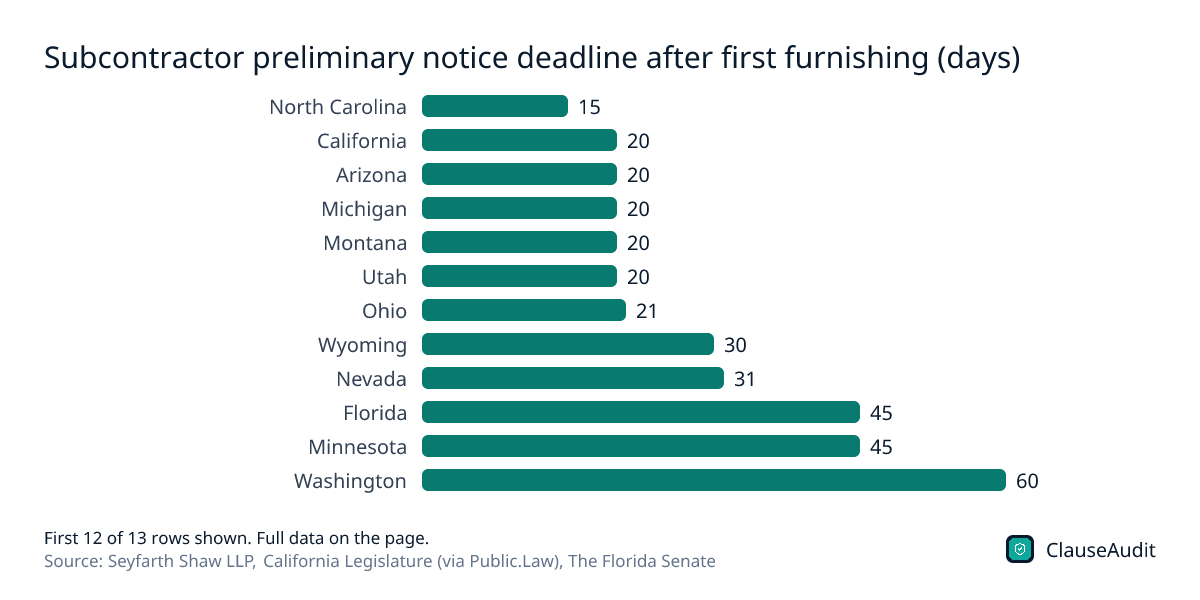

Subcontractor preliminary notice deadline after first furnishing (days)

Subcontractor preliminary notice deadline after first furnishing (days): North Carolina 15; California 20; Arizona 20; Michigan 20; Montana 20; Utah 20; Ohio 21; Wyoming 30; Nevada 31; Florida 45; Minnesota 45; Washington 60; New Mexico 60North Carolina15California20Arizona20Michigan20Montana20Utah20Ohio21Wyoming30Nevada31Florida45Minnesota45Washington60New Mexico60
Chart data
LabelValue
North Carolina15
California20
Arizona20
Michigan20
Montana20
Utah20
Ohio21
Wyoming30
Nevada31
Florida45
Minnesota45
Washington60
New Mexico60
Ohio applies only if a notice of commencement was filed; Montana exempts some claimants including commercial projects; Washington is 10 days on new single-family homes; New Mexico applies to liens over $5,000; North Carolina notice goes to the owner's lien agent. Source: Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update.

These notice clocks start on your first day, not your last. North Carolina's 15 days and the 20-day rule in California, Arizona, Michigan, Montana and Utah are easy to miss on a busy job.

Download this chart (PNG)

How an owner's recorded notice of completion shortens the lien deadline

StateNormal deadlineAfter a notice of completion
California90 days after completion60 days (prime) or 30 days (subs) after the notice is recorded
Arizona120 days after completion60 days after the notice is recorded
Nevada90 days after the latest of completion, last delivery or last work40 days after the notice is recorded
Alaska120 days after completing the contract or last furnishing15 days after the notice is recorded (for some claimants)
Utah180 days after final completion90 days after the notice is filed
Tennessee (prime)90 days after completion or abandonment30 days after the notice

Source: California Legislature (via Public.Law), California Civil Code § 8412; California Legislature (via Public.Law), California Civil Code § 8414; Arizona State Legislature, Arizona Revised Statutes § 33-993; Nevada Legislature (via Public.Law), Nevada Revised Statutes § 108.226; Alaska Legislature (via FindLaw), Alaska Statutes § 34.35.068; Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update. Download as image

Prime contractor lien filing deadline (default, private projects) by state

  • 2290 days or less
  • 1491 days to 4 months
  • 11More than 4 months
  • 4Other rule (calendar-month formula, notice-based or suit-based)
Prime contractor lien filing deadline (default, private projects). 90 days or less: California, Connecticut, District of Columbia, Florida, Georgia, Hawaii, Idaho, Indiana, Iowa, Massachusetts, Michigan, Mississippi, Montana, Nevada, New Jersey, North Dakota, Ohio, Oregon, South Carolina, Tennessee, Virginia, Washington. 91 days to 4 months: Alaska, Arizona, Arkansas, Colorado, Illinois, Kansas, Minnesota, Nebraska, New Hampshire, New Mexico, North Carolina, Oklahoma, South Dakota, West Virginia. More than 4 months: Alabama, Delaware, Kentucky, Maryland, Missouri, New York, Pennsylvania, Rhode Island, Utah, Wisconsin, Wyoming. Other rule (calendar-month formula, notice-based or suit-based): Louisiana, Maine, Texas, Vermont.Alabama: More than 4 monthsALAlaska: 91 days to 4 monthsAKArizona: 91 days to 4 monthsAZArkansas: 91 days to 4 monthsARCalifornia: 90 days or lessCAColorado: 91 days to 4 monthsCOConnecticut: 90 days or lessCTDelaware: More than 4 monthsDEDistrict of Columbia: 90 days or lessDCFlorida: 90 days or lessFLGeorgia: 90 days or lessGAHawaii: 90 days or lessHIIdaho: 90 days or lessIDIllinois: 91 days to 4 monthsILIndiana: 90 days or lessINIowa: 90 days or lessIAKansas: 91 days to 4 monthsKSKentucky: More than 4 monthsKYLouisiana: Other rule (calendar-month formula, notice-based or suit-based)LAMaine: Other rule (calendar-month formula, notice-based or suit-based)MEMaryland: More than 4 monthsMDMassachusetts: 90 days or lessMAMichigan: 90 days or lessMIMinnesota: 91 days to 4 monthsMNMississippi: 90 days or lessMSMissouri: More than 4 monthsMOMontana: 90 days or lessMTNebraska: 91 days to 4 monthsNENevada: 90 days or lessNVNew Hampshire: 91 days to 4 monthsNHNew Jersey: 90 days or lessNJNew Mexico: 91 days to 4 monthsNMNew York: More than 4 monthsNYNorth Carolina: 91 days to 4 monthsNCNorth Dakota: 90 days or lessNDOhio: 90 days or lessOHOklahoma: 91 days to 4 monthsOKOregon: 90 days or lessORPennsylvania: More than 4 monthsPARhode Island: More than 4 monthsRISouth Carolina: 90 days or lessSCSouth Dakota: 91 days to 4 monthsSDTennessee: 90 days or lessTNTexas: Other rule (calendar-month formula, notice-based or suit-based)TXUtah: More than 4 monthsUTVermont: Other rule (calendar-month formula, notice-based or suit-based)VTVirginia: 90 days or lessVAWashington: 90 days or lessWAWest Virginia: 91 days to 4 monthsWVWisconsin: More than 4 monthsWIWyoming: More than 4 monthsWY
  • 90 days or less22
  • 91 days to 4 months14
  • More than 4 months11
  • Other rule (calendar-month formula, notice-based or suit-based)4
StatePreliminary noticeLien deadline: prime contractorLien deadline: subcontractorDeadline to sue to enforceSource
AlabamaPrime: none. Subs: notice of intent to owner before filing; suppliers: before supplying materials6 months after last work or materials4 months after last work or materials (laborers 30 days)6 months after the debt matures (usually the last day of work)Ala. Code § 35-11-210 et seq.
AlaskaNotice of right to lien recommended before work starts (affects deadline)120 days after completing the contract or last furnishing; 15 days after a recorded notice of completion for some claimantsSame as prime6 months after the claim of lien is recordedAlaska Stat. §§ 34.35.068, 34.35.080
Arizona20-day preliminary notice from every claimant, including the prime, within 20 days of first furnishing120 days after completion, or 60 days after a recorded notice of completion, whichever is earlierSame as prime6 months after recording the claim of lienAriz. Rev. Stat. §§ 33-992.01, 33-993, 33-998
ArkansasNotice of intent at least 10 days before filing. Residential (4 units or fewer): prime gives owner notice before work; subs give notice of nonpayment within 75 days120 days after last labor or materialsSame as prime15 months after filing the lienArk. Code Ann. § 18-44-101 et seq.
California20-day preliminary notice within 20 days of first furnishing (prime to the lender; subs and suppliers to owner, prime and lender)After completing the contract and before the earlier of 90 days after completion of the project or 60 days after a recorded notice of completion or cessationBefore the earlier of 90 days after completion of the project or 30 days after a recorded notice of completion or cessation90 days after recording the claim of lienCal. Civ. Code §§ 8204, 8412, 8414, 8460
ColoradoNone. Notice of intent to file served at least 10 days before filing4 months after last labor or materials (2 months after completion for day or piece labor without materials)Same as prime6 months after completion of the improvement or last labor or materialsColo. Rev. Stat. § 38-22-109
ConnecticutPrime: none (optional affidavit within 15 days of starting work to receive notices). Subs: notice of intent no later than 90 days after work ends; serving the lien certificate can satisfy it90 days after last day of work; serve owners within 30 days of recordingSame as prime1 year after recording the lienConn. Gen. Stat. § 49-33 et seq.
DelawareList of everyone who furnished labor or materials within 10 days of the owner's requestStatement of claim and suit filed together within 180 days after completion of the structureStatement of claim and suit within 120 days after completing the sub's labor or last deliveryFiled with the statement of claim (same deadline)Del. Code Ann. tit. 25, § 2701 et seq.
District of ColumbiaNoneDuring construction or within 90 days after the earlier of completion or termination of the project; serve owner within 5 business daysSame as prime180 days after filing the notice of lienD.C. Code § 40-301.01 et seq.
FloridaPrime: statutory warning in contracts over $2,500. Subs and suppliers: Notice to Owner before or within 45 days after starting work90 days after final furnishing of labor, services or materialsSame as prime1 year after recording the claim of lien (60 days after an owner's notice of contest)Fla. Stat. §§ 713.015, 713.06, 713.08, 713.22
GeorgiaPrime: none. Subs and suppliers without a direct contract: Notice to Contractor within 30 days of the later of the notice of commencement filing or first furnishing (when a notice of commencement is filed)90 days after last furnishing labor, services or materialsSame as prime365 days after filing the lien (60 days after an owner's notice of contest)Ga. Code Ann. § 44-14-360 et seq.
HawaiiNoneApplication for lien filed within 45 days after completion of the improvementsSame as prime3 months after the court order directing the lien to attachHaw. Rev. Stat. § 507-41 et seq.
IdahoNone90 days after completion or cessation of labor, services or materials; serve owner within 5 business daysSame as prime6 months after filing the lienIdaho Code § 45-501 et seq.
IllinoisPrime: none. Subs: notice to owner within 90 days after completing work; 60 days after first furnishing on owner-occupied single-family homes4 months after completion to bind owner and third parties (up to 2 years after completion against the original owner only)Record within 4 months after completion (plus the 90-day notice)2 years after completion of the work (30 days after an owner's written demand)770 ILCS 60/0.01 et seq.
IndianaPrime: none. Subs: only on owner-occupied residential work (30 days for repairs, 60 days for new homes)90 days after last labor or materials (60 days for Class 2 structures)Same as prime1 year after recording the notice of intent to hold a lienInd. Code § 32-28-3-1 et seq.
IowaResidential: prime posts notice of commencement within 10 days of starting; subs post preliminary notice on the state lien registry. Commercial: sub-subs and suppliers to subs notify the prime within 30 daysPost on the mechanics' notice and lien registry within 90 days of last furnishing for full protection; later filings (up to 2 years and 90 days) are limited to the unpaid balanceSame as prime2 years after the 90-day filing period ends (30 days after an owner's written demand)Iowa Code § 572.1 et seq.
KansasNone for non-residential property4 months after last furnishing (extendable to 5 months on non-residential property by filing a notice of extension)3 months after last furnishing (extendable to 5 months on non-residential property)1 year after filing the lien statementKan. Stat. Ann. § 60-1101 et seq.
KentuckyPrime: none. Subs: notice of intent within 75 days of last furnishing (claims of $1,000 or less, or owner-occupied homes) or 120 days (claims over $1,000)6 months after last furnishing labor or materialsSame as prime12 months after filing the statement of lienKy. Rev. Stat. Ann. § 376.010 et seq.
LouisianaNotice of contract filed before work begins on contracts over $100,000Notice of contract filed: 60 days after an owner's notice of termination, or 7 months after substantial completion if none. No notice of contract: 60 days after notice of termination or substantial completionNotice of contract filed: 30 days after notice of termination, or 6 months after substantial completion if none. No notice of contract: 60 days1 year after filing the statement of claimLa. Rev. Stat. Ann. § 9:4801 et seq.
MaineNoneNo lien statement needed with a direct owner contract; must sue within 120 days after last labor or materialsRecord lien statement within 90 days after last labor or materials120 days after last labor, services or materialsMe. Rev. Stat. tit. 10, § 3251 et seq.
MarylandPrime: none. Subs: notice of intention to claim a lien within 120 days after last work or materialsPetition to establish the lien within 180 days after last work or materialsSame as prime1 year after filing the petition to establish the lienMd. Code Ann., Real Prop. § 9-101 et seq.
MassachusettsLower-tier subs and suppliers: notice of identification to the prime within 30 days of starting workNotice of contract by the earliest of 60 days after a notice of substantial completion, 90 days after a notice of termination, or 90 days after last furnishing; then statement of account by the earliest of 90, 120 or 120 days after the same eventsSame two-step rule as prime90 days after filing the statement of accountMass. Gen. Laws ch. 254, § 1 et seq.
MichiganPrime: none. Subs and suppliers: notice of furnishing within 20 days after first furnishing90 days after last furnishing labor or materialSame as prime1 year after recording the claim of lienMich. Comp. Laws § 570.1101 et seq.
MinnesotaPrime: preliminary notice in the written contract, or within 10 days after the work is agreed. Subs: within 45 days of first furnishing (residential and commercial buildings of 5,000 sq ft or less)120 days after last furnishing labor or materialsSame as prime1 year after last furnishing labor, skill or materialMinn. Stat. § 514.01 et seq.
MississippiSingle-family residential only: subs, suppliers and design professionals without a direct owner contract give a pre-lien notice at least 10 days before filing90 days after the claimant's last work, labor, services or materialsSame as prime180 days after filing the claim of lienMiss. Code Ann. §§ 85-7-405, 85-7-409
MissouriPrime: statutory disclosure notice to owner before first payment. Subs: notice to owner at least 10 days before filing6 months after the debt accruesSame as prime6 months after filing the lien statementMo. Rev. Stat. § 429.010 et seq.
MontanaPrime: none. Subs and suppliers: notice of right to claim a lien within 20 days of first furnishing (not required for some, including commercial projects)90 days after last furnishing services or materials (or after a notice of completion)Same as prime2 years after filing the lienMont. Code Ann. § 71-3-521 et seq.
NebraskaNone required (advisable when the owner is a protected party)120 days after final furnishing; serve owner within 10 days of recordingSame as prime2 years after recording (30 days after an owner's recorded demand)Neb. Rev. Stat. § 52-125 et seq.
NevadaPrime: residential notice of intent 15 days before recording. Subs and suppliers: preliminary notice within 31 days of first furnishing90 days after the latest of project completion, last delivery or last work; 40 days after a recorded notice of completionSame as prime6 months after recording the lienNev. Rev. Stat. § 108.226
New HampshirePrime: none. Subs and suppliers: notice to owner, ideally before furnishing, plus an account every 30 daysPerfect by suing and recording an attachment within 120 days of last furnishingSame as primeSuit and attachment are the perfection step (120 days)N.H. Rev. Stat. Ann. § 447:1 et seq.
New JerseyCommercial: none. Residential: Notice of Unpaid Balance and Right to File Lien within 60 days of last work, then arbitrationCommercial: 90 days after last work. Residential: 120 days after last work and within 10 days of the arbitrator's decisionSame as prime1 year after last work (30 days after a written demand)N.J. Stat. Ann. § 2A:44A-1 et seq.
New MexicoPrime: none. Subs and suppliers without a direct prime contract: notice within 60 days of first furnishing if the lien exceeds $5,000120 days after completing the contract90 days after substantial completion of the project2 years after filing the lienN.M. Stat. Ann. § 48-2-1 et seq.
New YorkNone (non-notice state)8 months after completion or final work or materials (4 months for a single-family home)Same as prime1 year after filing, unless a foreclosure action is started (with a notice of pendency) or an extension is filed with the county clerk; each extension adds up to 1 year (single-family homes: extension by court order only)N.Y. Lien Law §§ 10, 17
North CarolinaNotice to the owner's lien agent within 15 days after first furnishing120 days after last furnishing labor or materialsSame as prime (real property lien)180 days after last furnishingN.C. Gen. Stat. § 44A-7 et seq.
North DakotaWritten notice of intent by certified mail at least 10 days before recording90 days after the claimant's work or materials are completed (no later than 3 years after first furnishing)Same as prime3 years after recording (30 days after a written demand)N.D. Cent. Code § 35-27-01 et seq.
OhioPrime: none. Subs and suppliers: notice of furnishing within 21 days of first furnishing if the owner filed a notice of commencement75 days after last work or materials (60 days for certain homes and condominiums; 120 days for oil and gas wells)Same as prime6 years after filing (60 days after a notice to commence suit)Ohio Rev. Code Ann. § 1311.01 et seq.
OklahomaPrime: none. Subs: pre-lien notice within 75 days after last furnishing4 months after last furnishing labor or materials90 days after last furnishing1 year after filing the lien statementOkla. Stat. tit. 42, §§ 141-143
OregonPrime: information notice to owner at contract signing on residential jobs. Subs and suppliers: notice of right to lien; it protects only work from 8 days (excluding weekends and holidays) before deliveryEarlier of 75 days after last furnishing or 75 days after completion of constructionSame as prime120 days after recording the claim of lienOr. Rev. Stat. §§ 87.021, 87.035, 87.055
PennsylvaniaPrime: none. Subs: notice of furnishing within 45 days of first work if a notice of commencement is posted (projects of $1.5 million or more); notice of intent 30 days before filing6 months after completing its workSame as primeAction within 2 years of filing the lien claim49 P.S. § 1101 et seq.
Rhode IslandPrime: Notice of Possible Mechanic's Lien in the contract or given before work startsNotice of intention filed and served within 200 days after doing the workSame as primeLis pendens and complaint within 40 days after recording the notice of intentionR.I. Gen. Laws § 34-28-1 et seq.
South CarolinaSubs and suppliers should notify the owner of furnishing before the lien attaches90 days after ceasing to furnish labor or materialsSame as prime6 months after ceasing to furnish labor or materialsS.C. Code Ann. § 29-5-10 et seq.
South DakotaPrime: none. Second-tier subs and suppliers: notice within 60 days of last furnishing if a notice of project commencement was filed120 days after last workSame as prime6 years after last work (30 days after an owner's demand)S.D. Codified Laws § 44-9-1 et seq.
TennesseePrime: none on most projects. Subs: notice of nonpayment within 90 days of the last day of each month of workRecord within 90 days after the improvement is completed or abandoned (30 days after an owner's notice of completion)90 days after completion or abandonmentPrime: 1 year after work is finished. Subs: 90 days after recordingTenn. Code Ann. § 66-11-101 et seq.
TexasPrime: none. Subs and suppliers: notice by the 15th day of the 3rd month after each month of work (2nd month on residential)15th day of the 4th month after the month the work was completed, terminated or abandoned (3rd month on residential)15th day of the 4th month after the month of last labor or materials (3rd month on residential)1 year after the last day the lien affidavit could be filedTex. Prop. Code §§ 53.052, 53.056, 53.158
UtahPreliminary notice on the State Construction Registry within 20 days after starting work (all claimants, including the prime)180 days after final completion of the original contract; 90 days after a notice of completion (but no later than 180 days)Same as prime180 days after recording the notice of lienUtah Code Ann. § 38-1a-501 et seq.
VermontNone (optional pre-lien notice sets priority)Written notice of lien to owner; to last beyond 180 days after payment was due, also record a memorandum of lien with the town clerkSame as prime180 days after recording the memorandum (if payment is due) or after payment becomes dueVt. Stat. Ann. tit. 9, § 1921 et seq.
VirginiaNone, except optional notice to a mechanic's lien agent on 1-2 family homes within 30 days of first furnishing90 days from the last day of the month of last work, and no later than 90 days after the structure is completed or work ends (covers only work from the prior 150 days, except retainage)Same as prime6 months after recording, or 60 days after completion, whichever is laterVa. Code Ann. § 43-1 et seq.
WashingtonPrime: generally none. Subs and suppliers without a direct contract: notice within 60 days of first furnishing (10 days on new single-family homes)90 days after ceasing to furnish labor, services, materials or equipmentSame as prime8 calendar months after recording the lienRev. Code Wash. § 60.04.091
West VirginiaNone (optional notice)100 days after completion of the contract100 days after last furnishing6 months after filing the notice of lienW. Va. Code § 38-2-1 et seq.
WisconsinResidential (fewer than 4 units): prime notice in the contract or within 10 days; subs within 60 days of first furnishing. Notice of intent 30 days before filing6 months after last labor, services or materialsSame as prime2 years after filing the lien claimWis. Stat. § 779.01 et seq.
WyomingPrime: notice of lien rights to owner before any payment. Subs: notice within 30 days of first furnishing. Notice of intent 20 days before filing150 days after last work or substantial completion, whichever is earlier120 days after last work or substantial completion, whichever is earlier180 days after filing the lien statementWyo. Stat. Ann. § 29-1-201 et seq.

How long do you have to file a mechanics lien?

For a prime contractor on a private project, the answer is usually short. Our tally of the 50 states and DC puts 22 jurisdictions at 90 days or less, 14 between 91 days and 4 months, and 11 at more than 4 months. The other 4, Louisiana, Maine, Texas and Vermont, use a different rule altogether.

Some windows are tight. Hawaii gives 45 days after completion. Oregon and Ohio give 75 days. California, Florida, Georgia, Michigan, Nevada and Washington sit at 90 days. At the long end, New York allows 8 months, but only 4 months on a single-family home, and Rhode Island allows 200 days for its notice of intention.

Texas counts in months, not days. On a commercial job the lien affidavit is due by the 15th day of the 4th month after the month your work ended. On residential work it is the 3rd month. So if you finish on the last day of a month, you lose most of a month compared with someone who finished on the first.

What is a preliminary notice and when is it due?

A preliminary notice tells the owner, and often the lender and prime contractor, that you are on the job and expect to be paid. Many states make it a condition of lien rights for subs and suppliers who did not sign with the owner. Skip it and the later lien may fail even if you file on time.

The deadlines are early. North Carolina wants notice to the owner's lien agent within 15 days of first furnishing. California, Arizona, Michigan, Montana and Utah use 20 days. Ohio uses 21 days when the owner filed a notice of commencement. Florida subs and suppliers get 45 days to serve a Notice to Owner, and Washington gives 60 days, or 10 days on a new single-family home.

California has a useful safety net. A late notice still counts, but it only covers work from 20 days before you served it. That means sending a notice on day 50 does not save the first month of work. The lesson is simple: send the notice in your first week, every time, even for clients you trust.

When does the lien clock start?

Most states count from your last day of furnishing labor or materials. California, Arizona, Hawaii, Delaware, Utah and West Virginia count from completion of the contract or the project instead. That difference matters if you finish your part early and the building keeps going for months.

The owner can also shorten your window. In California a recorded notice of completion cuts the deadline to 60 days for a prime and 30 days for a sub. Arizona drops to 60 days. Nevada drops to 40 days. Alaska can drop to 15 days for some claimants, and Tennessee to 30 days for the prime.

Here is how that plays out. A drywall sub in California finishes in March. The project wraps in June, and the owner records a notice of completion. The sub now has 30 days from that recording, not 90 days from completion. Do not count on hearing about the notice in time. Ask in writing to be told when one is recorded, and check the county records yourself near the end of any job.

What happens after you record the lien?

A recorded lien does not last forever. You have to sue to enforce it, and that deadline can be short. In California you must file suit within 90 days of recording. Massachusetts also gives 90 days, counted from the statement of account. Rhode Island gives just 40 days after recording the notice of intention.

Other states are more relaxed. Florida keeps a lien alive for 1 year after recording unless you sue, though an owner's notice of contest can cut that to 60 days. Oregon allows 120 days, and DC, Mississippi, Utah and Wyoming allow 180 days.

In practice, recording the lien often gets the client to the table, because a title search will show it to any buyer or lender. If it does not, talk to a construction lawyer well before the enforcement date. A lien that lapses is worth nothing, and by then it is usually too late to record a new one for the same work.

What should you do the day you start a job?

  • Look up the state in the table below and write both deadlines on the job file: the preliminary notice date and the last possible lien date.
  • Get the owner's legal name, the property's legal description and the lender's details before you start. You need them for the notice and the lien.
  • Serve the preliminary notice in the first week, by a method the statute allows, and keep proof of delivery.
  • Track your last day of furnishing. Keep delivery tickets and timesheets so you can prove it later.
  • Ask the owner or prime to tell you in writing if a notice of completion or commencement is recorded.
  • Set calendar reminders well ahead of the lien deadline and the deadline to sue, not on the day itself.

Do lien rights cover freelancers and small trades?

They cover people who improve real property: prime contractors, subs, suppliers, laborers, and in some states design professionals. A freelance designer who only builds a website has no lien rights. A freelance carpenter, electrician or tile setter usually does.

Check which side of the job you sit on, too. A prime with a direct contract with the owner often has no preliminary notice duty, while a sub or supplier lower down the chain usually does. The rules for small residential jobs are often stricter. New York cuts its window to 4 months on a single-family home. Texas moves its deadline up by a month on residential work. Washington's notice drops to 10 days on new single-family homes. If most of your work is in homes, read the residential note for your state before you rely on the headline number.

How ClauseAudit helps

Lien rights are your backup plan. Your contract is the first line of defense, and it decides how fast you get paid, what counts as complete, and whether you can stop work when a payment is late.

Run your agreement through an automated review before you sign. It flags payment terms that push your money past the lien window, waivers of lien rights, and vague completion language that makes your deadline hard to pin down.

  • Payment terms: due dates that fall well inside your state's lien deadline, not after it
  • Lien waivers: any clause that gives up lien rights before you are paid, or unconditional waivers tied to progress payments
  • Completion and acceptance: a clear definition of when your work is finished, so your clock is easy to prove
  • Pay-when-paid or pay-if-paid language that ties your payment to the owner paying someone else
  • Late fees and the right to stop work if an invoice goes unpaid
  • Notice provisions: who must tell you when a notice of completion or commencement is recorded
Review your contract

Frequently asked questions

What is the shortest mechanics lien deadline in the US?

Among states that count in days, Hawaii is the shortest for a prime contractor, at 45 days after completion of the improvements. Oregon and Ohio follow at 75 days. A recorded notice of completion can make some windows even shorter, such as 15 days for some claimants in Alaska or 30 days for subs in California.

How long do I have to file a mechanics lien in California?

No more than 90 days after the project is completed. If the owner records a notice of completion or cessation, that drops to 60 days for a prime contractor and 30 days for a sub or supplier. You also need a preliminary notice within 20 days of first furnishing, and you must sue within 90 days of recording the lien.

What is the Florida Notice to Owner deadline?

Subcontractors and suppliers must serve a Notice to Owner before starting work or within 45 days after they start. The claim of lien itself is due within 90 days of final furnishing. Once recorded, the lien lasts 1 year unless you file suit, or 60 days if the owner serves a notice of contest.

How does the Texas lien deadline work?

Texas counts by calendar month. On commercial projects the lien affidavit is due by the 15th day of the 4th month after the month the work was completed, terminated or abandoned. On residential projects it is the 15th day of the 3rd month. Subs also send monthly notices on a similar month-based schedule.

How long do I have to file a mechanics lien in New York?

New York gives 8 months after completion or your final work or materials. On a single-family home the window is 4 months. New York does not require a preliminary notice, but the lien expires 1 year after filing unless you start a foreclosure action or file an extension.

Can I still file a lien if I missed the preliminary notice?

It depends on the state. In some, a missed notice ends your lien rights entirely. California is more forgiving: a late notice still works, but it only covers work from 20 days before you served it onward. Earlier unpaid work falls outside the lien, so serve notice early.

Does a lien last forever once it is recorded?

No. Every state sets a deadline to sue to enforce it. Rhode Island allows 40 days after the notice of intention, California and Massachusetts 90 days, Oregon 120 days, and DC, Mississippi, Utah and Wyoming 180 days. If you do not sue in time, the lien lapses and the property is cleared.

Should I sign a contract that waives my lien rights?

Be very careful. Many states limit advance waivers, but a broad waiver in your contract can still cause trouble and stall a collection. Ask to strike it, or swap it for conditional waivers that take effect only when each payment actually clears. Have a lawyer in your state look at any waiver before you sign.

Use this data

Every chart and card below is free to reuse under CC BY 4.0. Download what you need and link back to this page.

Embed the infographic

Free to share on your site, blog or slides under CC BY 4.0. Please keep the credit link.

Mechanics Lien Deadlines by State: Preliminary Notice and Filing Windows
Download PNG

Sources and method

Every number on this page comes from the sources below, each opened and read on or before October 18, 2026. A second, independent review checked every figure against its source and corrected anything that did not match. 51 of 51 state entries were confirmed; any that could not be are marked "Not yet confirmed" and left out of every count and chart.

  1. Seyfarth Shaw LLP, 50 State Lien Law Notice Requirements, 2025 Update (May 2025 (statutes in effect as of May 1, 2025))
  2. California Legislature (via Public.Law), California Civil Code § 8204 (Section updated Jan. 1, 2011; verified Oct. 12, 2026)
  3. California Legislature (via Public.Law), California Civil Code § 8412 (Section updated Jan. 1, 2011; verified Oct. 12, 2026)
  4. California Legislature (via Public.Law), California Civil Code § 8414 (Section updated Jan. 1, 2011; verified Oct. 12, 2026)
  5. California Legislature (via Public.Law), California Civil Code § 8460 (Section updated Jan. 1, 2011; verified Oct. 12, 2026)
  6. Texas Legislature (via Public.Law), Texas Property Code § 53.052 (As amended by H.B. 2237 (2021), effective Jan. 1, 2022; verified May 26, 2025)
  7. Texas Legislature (via Public.Law), Texas Property Code § 53.056 (Effective Jan. 1, 2022; verified May 26, 2025)
  8. Texas Legislature (via Public.Law), Texas Property Code § 53.158 (Verified May 26, 2025)
  9. The Florida Senate, Florida Statutes § 713.06 (2026 Florida Statutes)
  10. The Florida Senate, Florida Statutes § 713.08 (2026 Florida Statutes)
  11. The Florida Senate, Florida Statutes § 713.22 (2026 Florida Statutes)
  12. New York State Senate, New York Lien Law § 10 (Text as revised 2014-09-22)
  13. New York State Senate, New York Lien Law § 17 (Current text as accessed Oct. 2026)
  14. Arizona State Legislature, Arizona Revised Statutes § 33-993 (Current text as accessed Oct. 2026)
  15. Arizona State Legislature, Arizona Revised Statutes § 33-992.01 (Current text as accessed Oct. 2026)
  16. Washington State Legislature, Revised Code of Washington § 60.04.091 (Current text as accessed Oct. 2026)
  17. Colorado General Assembly (via Public.Law), Colorado Revised Statutes § 38-22-109 (2024 C.R.S.; site current through Fall 2025)
  18. Oregon Legislature (via Public.Law), Oregon Revised Statutes § 87.035 (2023 ORS with 2024 changes; current through early 2026)
  19. Oregon Legislature (via Public.Law), Oregon Revised Statutes § 87.021 (2023 ORS with 2024 changes; current through early 2026)
  20. Nevada Legislature (via Public.Law), Nevada Revised Statutes § 108.226 (Accessed by publisher May 26, 2025)
  21. Mississippi Legislature (via FindLaw), Mississippi Code § 85-7-405 (Current text as accessed Oct. 2026)
  22. Mississippi Legislature (via FindLaw), Mississippi Code § 85-7-409 (Current text as accessed Oct. 2026)
  23. Alaska Legislature (via FindLaw), Alaska Statutes § 34.35.068 (Current text as accessed Oct. 2026)

Cite this page

ClauseAudit, “Mechanics Lien Deadlines by State: Preliminary Notice and Filing Windows”, updated October 18, 2026, https://clauseaudit.com/data/mechanics-lien-deadlines-by-state. Free to reuse with a link back (CC BY 4.0).

This page summarises published data and law as checked on October 18, 2026. Figures are updated as new editions are released, and your own situation may differ. It is general information, not legal, tax or financial advice.
